Why in News?
On 15 July 2026, the Cabinet Committee on Economic Affairs approved two Ministry of Railways multitracking projects: doubling of the Paradeep-Haridaspur section and construction of a fourth line between Rajkharsawan and Dangoaposi. The PIB release places both projects within an integrated freight, connectivity and regional-development framework.
The approval carries a combined estimated cost of approximately ₹3,907 crore, is targeted for completion up to 2030-31, and is expected to add about 145 km to the Indian Railways network. These are aggregate package figures: the release does not provide separate project-wise lengths or costs, so no line-wise split should be inferred from the total.
- The package covers four districts across Odisha and Jharkhand and is expected to improve connectivity for about 1,526 villages with a population of roughly 14 lakh.
- PIB estimates additional freight traffic of 44 MTPA, where MTPA means million tonnes per annum; this is an expected traffic magnitude from capacity augmentation, not a guaranteed engineering ceiling or actual traffic already carried.
- The routes carry bulk commodities such as coal and iron ore, along with dolomite, limestone and gypsum, making the approval relevant to mineral supply chains and port-linked logistics.
- The official appraisal associates the package with a reduction in oil import of 6 crore litres and lower CO₂ emissions of 29 crore kg, equivalent in the release to planting one crore trees.
- PIB does not specify a time period for the oil and CO₂ totals in this release; they should be read as project-appraisal estimates, not automatically labelled as annual savings.
The development matters in the context of:
- India’s bulk freight challenge is not only about laying track; it is about removing line-capacity bottlenecks between mines, industrial users, junctions and ports.
- A congested rail section can push time-sensitive or diverted freight towards roads, so modal balance depends on reliable rail paths, terminals and last-mile links.
- The approval links PM Gati Shakti integrated planning with logistics efficiency, but realised gains will depend on coordinated execution beyond the track itself.
- Green logistics requires both lower-emission transport and safeguards against the local ecological and social costs of construction and expanded mineral movement.

UPSC Relevance
Prelims Relevance
- The Cabinet Committee on Economic Affairs is a Cabinet committee that considers major economic and infrastructure proposals; the approved projects belong to the Ministry of Railways.
- The Paradeep-Haridaspur proposal is a doubling project, while Rajkharsawan-Dangoaposi is a fourth-line project.
- Multitracking means adding one or more parallel tracks to an existing railway corridor to increase train paths and reduce conflicts between movements.
- MTPA expands to million tonnes per annum and is commonly used to express the scale of bulk commodity traffic or industrial capacity.
- The two-project package covers Odisha and Jharkhand, about 145 km of network addition and four districts.
- The official completion horizon is up to 2030-31, while the combined estimated cost is approximately ₹3,907 crore.
- The release identifies coal, iron ore, dolomite, limestone and gypsum among the commodities moved on these essential routes.
- The projects were planned under the PM Gati Shakti National Master Plan, which stresses integrated planning, multimodal connectivity and stakeholder consultation.
- A functional mineral freight corridor is a route serving mineral flows; it should not be confused automatically with a separately notified Dedicated Freight Corridor.
Mains Relevance
GS Paper 3
- Infrastructure: railway capacity augmentation, congestion removal, operational efficiency, service reliability and multimodal planning under PM Gati Shakti.
- Indian economy: mineral supply chains, port connectivity, logistics costs, industrial competitiveness and the crowding-in effect of dependable trunk infrastructure.
- Environment: rail-road modal choice, energy efficiency, oil-import dependence, emissions appraisal and the need to account for construction-stage impacts.
GS Paper 2
- Cooperative governance: coordination among the Union government, two state governments, Indian Railways, ports, industry and district administrations.
- Inclusive development: village connectivity, access to services, local employment and fair management of land, forests and community concerns.
Essay
- Infrastructure is a system, not a collection of isolated assets: track, terminals, ports, roads, power and institutions must work together.
- The quality of development is measured not only by freight moved, but also by who gains, who bears the cost and what emissions are avoided.
- A lower-carbon economy needs practical choices in ordinary systems such as freight transport, not climate policy in a separate silo.
Background and Context

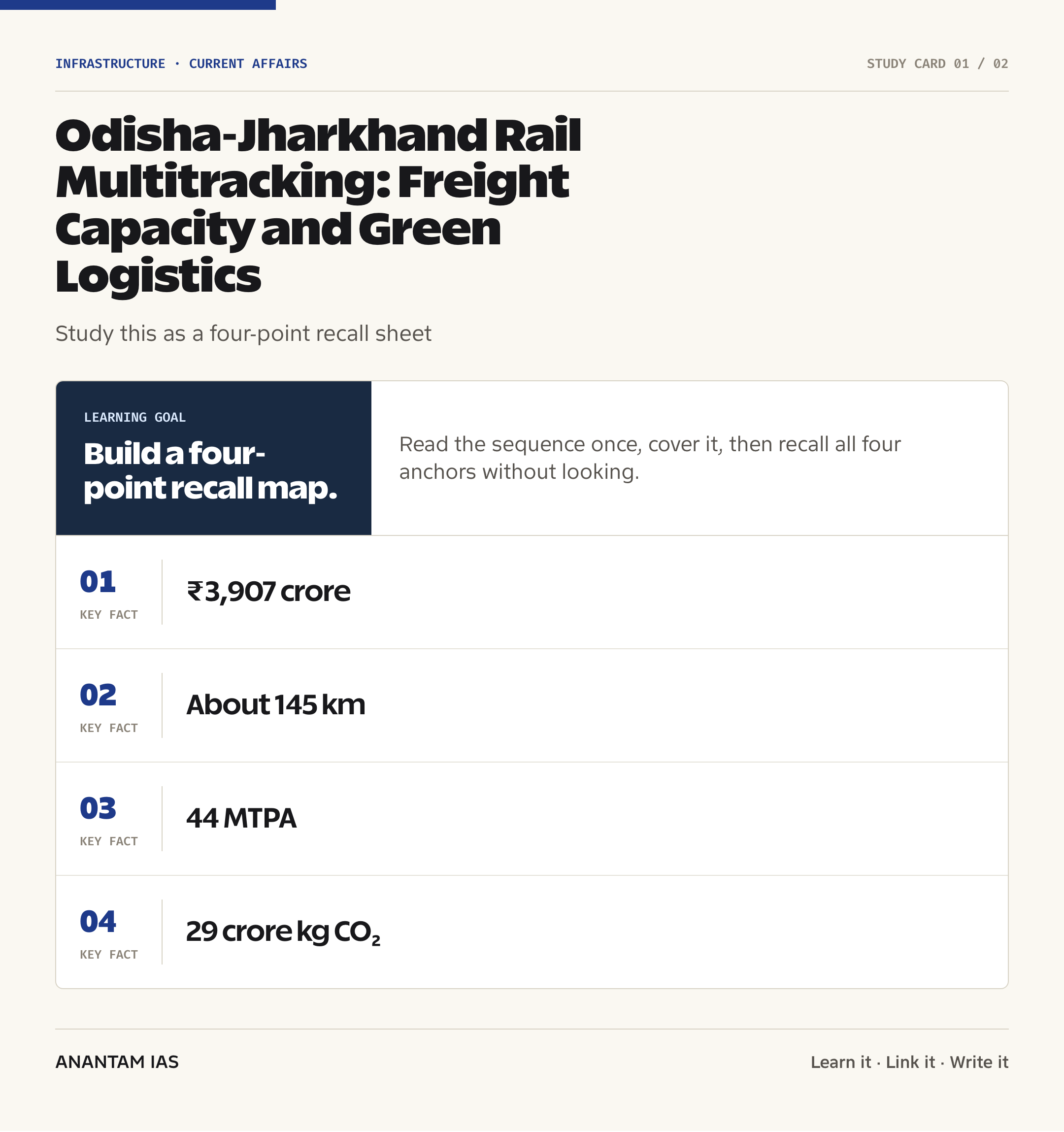

The Approval at a Glance
The decision combines two different capacity interventions into one CCEA approval package.
- Paradeep-Haridaspur doubling adds a second track to the existing section, creating more scope for simultaneous movement and reducing dependence on crossings at selected stations.
- The Rajkharsawan-Dangoaposi fourth line adds another parallel track to an already multitracked corridor, aimed at easing a heavier concentration of train movements.
- The two projects together have an estimated cost of about ₹3,907 crore and a completion horizon up to 2030-31.
- Their combined network addition is about 145 km; PIB does not publish a separate length, cost or freight figure for each project in this release.
- This aggregate presentation matters for interpretation: ₹3,907 crore cannot be assigned between the two routes, and 44 MTPA cannot be allocated route-wise, without another official project document.

How Multitracking Expands Railway Capacity
Rail capacity depends on how many safe train paths a section can offer within a timetable, not merely on its map length.
- On a single line, trains moving in opposite directions may need to wait at crossing stations; a second line can reduce these conflicts and improve average movement.
- On a busy multitrack corridor, a fourth line can create additional paths, permit better separation of trains with different speeds or stopping patterns, and provide operating flexibility during maintenance.
- Fewer conflicting movements can improve service reliability, wagon turnaround and the ability to schedule passenger and freight trains without one category repeatedly displacing the other.
- Track addition alone is not sufficient. Real capacity also depends on signalling, junctions and yards, bridges, traction power, loading terminals, rolling stock and disciplined timetabling.
- The release’s 44 MTPA figure describes expected additional freight traffic from the capacity works; it is not the physical weight of track, the present traffic level or an automatic outcome on the completion date.
Why These Are Mineral Freight Routes
A mineral freight corridor links extraction and processing regions with industrial consumers, storage points and ports through a high-volume transport chain.
- PIB identifies coal, iron ore, dolomite, limestone and gypsum as commodities for which these routes are essential.
- These materials are bulky, heavy and required in large volumes by sectors such as steel, power and cement, so reliable mass transport affects inventory planning and production continuity.
- The Paradeep side gives the package a clear port-connectivity dimension, while the Odisha-Jharkhand geography connects the approval with an important mineral and industrial region.
- The phrase mineral freight corridor describes the economic function of the routes. It does not by itself mean that either section is part of a statutory or branded Dedicated Freight Corridor.
- The release treats the two lines as one package and does not assign individual commodities or tonnage to either one; route-specific claims should await detailed railway project reports.
Rail, Road and the Logistics-Cost Channel
Rail and road perform different parts of a freight chain, so the policy issue is efficient modal allocation rather than a simplistic contest between them.
- Rail is suited to moving large, regular bulk loads over trunk routes because one train can consolidate many wagon-loads into a single scheduled movement.
- Road transport retains an advantage in door-to-door flexibility, dispersed origins and destinations, shorter hauls and first- or last-mile collection.
- A congested rail line raises waiting, uncertainty and wagon-cycle time. Added paths can lower these reliability costs, even when the published approval does not quantify a rupee reduction in national logistics cost.
- Rail cannot deliver the expected gain if minerals queue at loading points, trains face junction delays or port evacuation is constrained. End-to-end logistics must connect track capacity with terminals and handling systems.
- PM Gati Shakti is relevant because integrated planning can sequence railway, port, road, industrial and utility works around the same freight geography.
- A shift from road to rail is possible only when rail service is dependable and commercially workable; the approval itself does not state how much road freight will shift.
Reading the Green-Logistics Claims Carefully
The environmental case rests on rail’s energy-efficient bulk movement and reduced petroleum dependence, but appraisal estimates need precise labels.
- PIB describes railways as an environment-friendly and energy-efficient transport mode and links the projects with climate goals and lower logistics cost.
- Its appraisal estimates a reduction in oil import of 6 crore litres and lower CO₂ emissions of 29 crore kg for the project package.
- The release equates the CO₂ reduction with planting one crore trees. This is a communication equivalence, not a substitute for actual afforestation or an independently verified carbon credit.
- No time horizon or calculation method is given for the oil and emissions totals in the release. Calling them annual figures would add a claim that the cited source does not make.
- The mechanism is credible in direction: efficient rail movement and electric traction can reduce direct diesel use relative to moving comparable bulk freight by many road vehicles. The realised benefit depends on traffic actually shifted, train loading, electricity source and operations.
- A complete environmental assessment must also examine construction emissions, land and forest impacts, noise, dust, water, wildlife movement and the induced effects of expanded mineral extraction.
Regional Development and Connectivity
Freight infrastructure can create wider regional gains when local connectivity and public services improve alongside industrial throughput.
- The package is expected to enhance connectivity for about 1,526 villages with a combined population of approximately 14 lakh across four districts.
- PIB also identifies Lalitgiri Buddhist Complex, Shree Baladevjew Temple and Meghahatuburu Hills among tourist destinations likely to gain from improved rail connectivity.
- Better rail operations can support labour mobility, market access and the movement of inputs and finished goods, but a freight-heavy line does not automatically guarantee suitable passenger frequency or affordable local access.
- Construction and associated services may create employment and self-employment, while durable gains require local skills, transparent procurement and links with regional enterprises.
- Benefits should be assessed district-wise because aggregate village and population figures can conceal uneven access, displacement burdens or gaps in last-mile connectivity.
Implementation Risks and Public Accountability
The value of an approval depends on timely delivery, safe operation and transparent measurement after commissioning.
- The 2030-31 horizon requires coordinated land availability, clearances, utility shifting, bridge and yard work, procurement and construction without prolonged traffic disruption.
- Because the projects cross two states and four districts, intergovernmental coordination must align railway engineering with district administration, environmental conditions and local infrastructure.
- Cost monitoring should separate the approved estimate from later expenditure, escalation and scope changes. The phrase approximately ₹3,907 crore is not a final audited outlay.
- Performance reporting should track section capacity, average detention, freight carried, reliability, safety and passenger effects instead of treating kilometres laid as the only output.
- Environmental claims should be checked after commissioning against actual traffic and energy data, with the assumptions behind oil and CO₂ estimates disclosed.
- Consultation should cover affected communities, workers and local bodies so national logistics gains do not externalise social and ecological costs onto the corridor districts.
- A transparent monitoring dashboard can distinguish inputs, outputs and outcomes: expenditure and land availability are inputs; commissioned track and upgraded yards are outputs; lower detention, reliable train paths and freight actually carried are outcomes. This distinction prevents physical completion from being presented as proof that every economic benefit has already materialised.
- Independent safety and environmental audits should continue during construction and early operation. A corridor carrying more heavy freight needs attention to level crossings, track maintenance and emergency readiness, while district authorities need usable information on noise, dust, drainage and community complaints. Public disclosure can help correct problems before they become recurring operational or social costs.
Way Forward
Complete the Whole Capacity Chain
- Synchronise new tracks with signalling, yards, junction remodelling, traction power and terminal capacity so bottlenecks do not simply move to the next node.
- Coordinate mine sidings, industrial terminals and Paradeep-linked port logistics through PM Gati Shakti planning.
- Protect passenger paths and maintenance windows through transparent, safety-led timetable design.
Measure Outcomes, Not Only Construction
- Publish baseline and post-project indicators for train detention, line use, freight volume, wagon turnaround and service reliability.
- Report the 44 MTPA estimate against actual incremental traffic without presenting projections as delivered outcomes.
- Disclose project-wise physical progress, expenditure and revised milestones because the approval release supplies only package-level totals.
Make Green Freight Verifiable
- State the baseline, appraisal period and modal-shift assumptions behind oil and CO₂ estimates in detailed project monitoring.
- Track traction energy, train loading and displaced road movement after commissioning to test the claimed emissions advantage.
- Apply mitigation for forests, drainage, dust, noise and wildlife movement, and treat the tree equivalence as an explanatory device rather than compliance.
Share Regional Benefits Fairly
- Connect corridor investment with last-mile roads, stations and local services for the villages identified in the project area.
- Use local skilling and procurement where feasible, while enforcing fair compensation, rehabilitation and worker safety.
- Create accessible district-level grievance and consultation channels throughout construction and early operation.
Conclusion
The Odisha-Jharkhand package shows why rail multitracking is economic infrastructure, not merely an engineering upgrade. By adding paths on mineral and port-linked routes, it can improve freight reliability, support industry and create room for a better rail-road balance.
Its green and developmental case should still be tested through evidence. The decisive questions are whether the projects deliver the expected 44 MTPA, reduce oil use and emissions under disclosed assumptions, protect local communities and ecosystems, and convert national logistics efficiency into broad regional benefit.

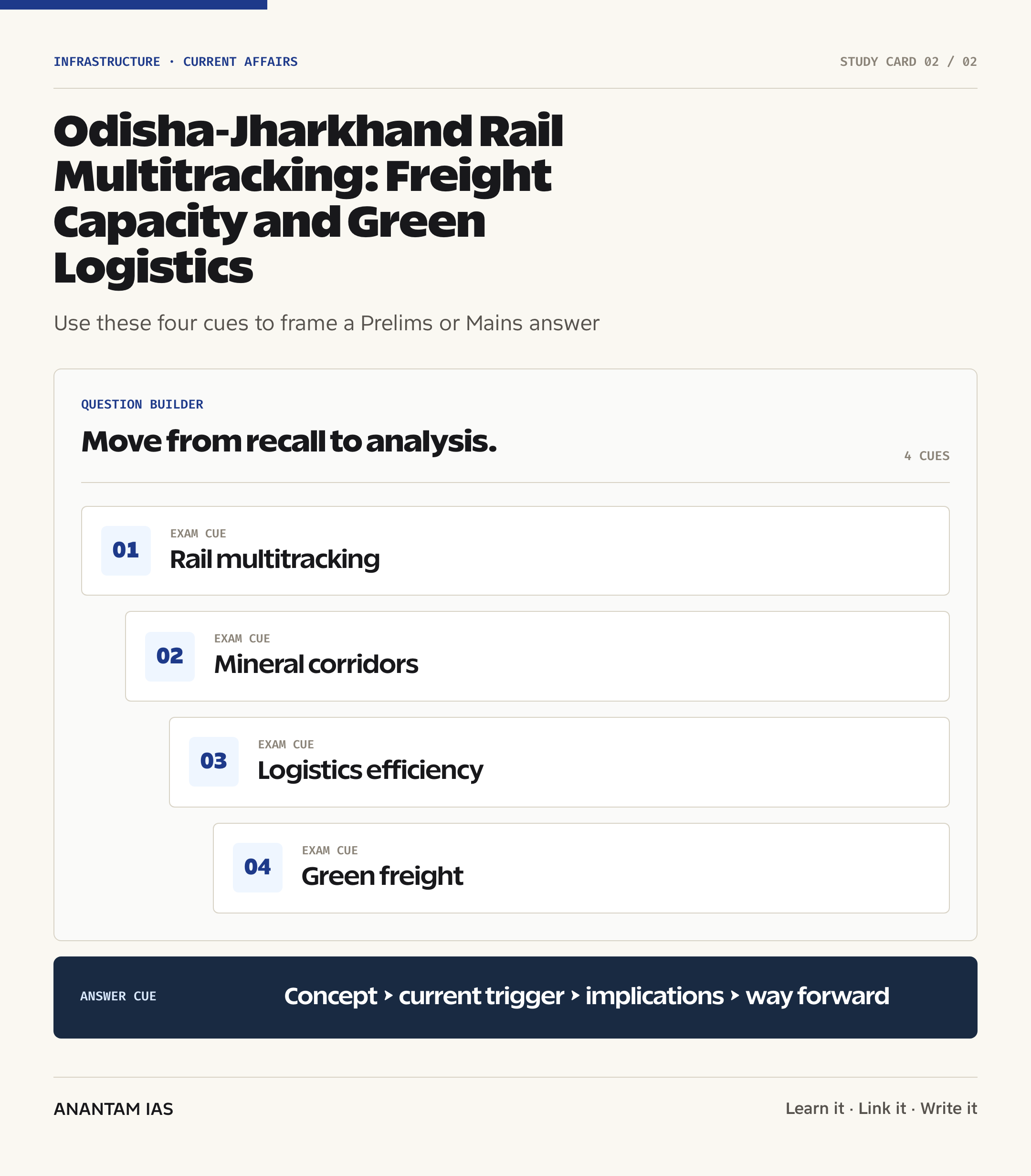

UPSC Practice Questions
Prelims MCQ 1
With reference to the CCEA-approved Odisha-Jharkhand rail multitracking package, consider the following statements:
- It includes doubling of the Paradeep-Haridaspur section.
- It includes a fourth line between Rajkharsawan and Dangoaposi.
- The PIB approval release provides separate cost estimates for each project.
How many of the above statements are correct?
(a) Only one (b) Only two (c) All three (d) None
Answer: (b) Only two
Explanation:
Statements 1 and 2 are correct. The release gives a combined approximate cost of ₹3,907 crore and does not break that amount down project-wise.
Prelims MCQ 2
In the official appraisal of the two rail projects, what does 44 MTPA represent?
(a) The combined length of the new tracks (b) The expected additional freight traffic from capacity augmentation (c) The estimated reduction in carbon dioxide emissions (d) The annual petroleum import bill of Indian Railways
Answer: (b) The expected additional freight traffic from capacity augmentation
Explanation:
PIB describes 44 MTPA as the magnitude of additional freight traffic expected from the capacity augmentation works. It is not route length, emissions reduction or an import bill.
UPSC Mains Questions
- Railway multitracking can lower logistics friction only when the entire freight chain is upgraded. Discuss with reference to track capacity, terminals, ports, signalling, last-mile links and institutional coordination in mineral-producing regions.
- Examine the economic and environmental case for shifting suitable bulk freight from road to rail. What indicators should be used to verify claims concerning freight capacity, oil savings and lower carbon emissions?
- Infrastructure-led regional development can produce national gains while concentrating local costs. Suggest a framework for ensuring that mineral freight corridors improve village connectivity, employment and industrial competitiveness without weakening social and ecological safeguards.
Source: PIB, Cabinet Committee on Economic Affairs.
Frequently Asked Questions
What did the CCEA approve?
It approved two Ministry of Railways projects: Paradeep-Haridaspur doubling and a fourth line from Rajkharsawan to Dangoaposi. Together, they are intended to relieve congestion, add train paths and improve freight and passenger movement across parts of Odisha and Jharkhand.
What are the official cost and length?
PIB gives a combined estimated cost of approximately ₹3,907 crore and says the two projects will add about 145 km to the railway network. The release does not provide separate project-wise lengths or costs, so splitting these totals would be unsupported.
What does multitracking mean?
Multitracking means adding parallel tracks to an existing rail corridor. Doubling adds a second line; a fourth-line project adds another line to a corridor that already has multiple tracks. More tracks can reduce train conflicts, create additional paths and improve maintenance flexibility and reliability.
Why are these mineral freight corridors?
The routes serve flows of coal, iron ore, dolomite, limestone and gypsum, connecting mineral and industrial areas with users and port-linked logistics. Here, mineral freight corridor describes an economic function; it does not automatically identify a route as part of a separately notified Dedicated Freight Corridor.
Does 44 MTPA mean guaranteed capacity?
No. PIB calls 44 MTPA the magnitude of additional freight traffic expected from the capacity augmentation works. Actual traffic will depend on commissioning, demand, terminals, rolling stock, train paths and operations. It should not be treated as freight already carried or a guaranteed route-wise result.
How strong is the green claim?
PIB estimates reduced oil import of 6 crore litres and lower CO₂ emissions of 29 crore kg, with a one-crore-tree equivalence. The release does not state the appraisal period or methodology, so verification needs disclosed assumptions and post-commissioning traffic and energy data.
